Skip to content

Statistics & Dashboards

RushTI tracks every run in a local SQLite database. You can query execution history, export reports, and generate interactive HTML dashboards — no database server required.

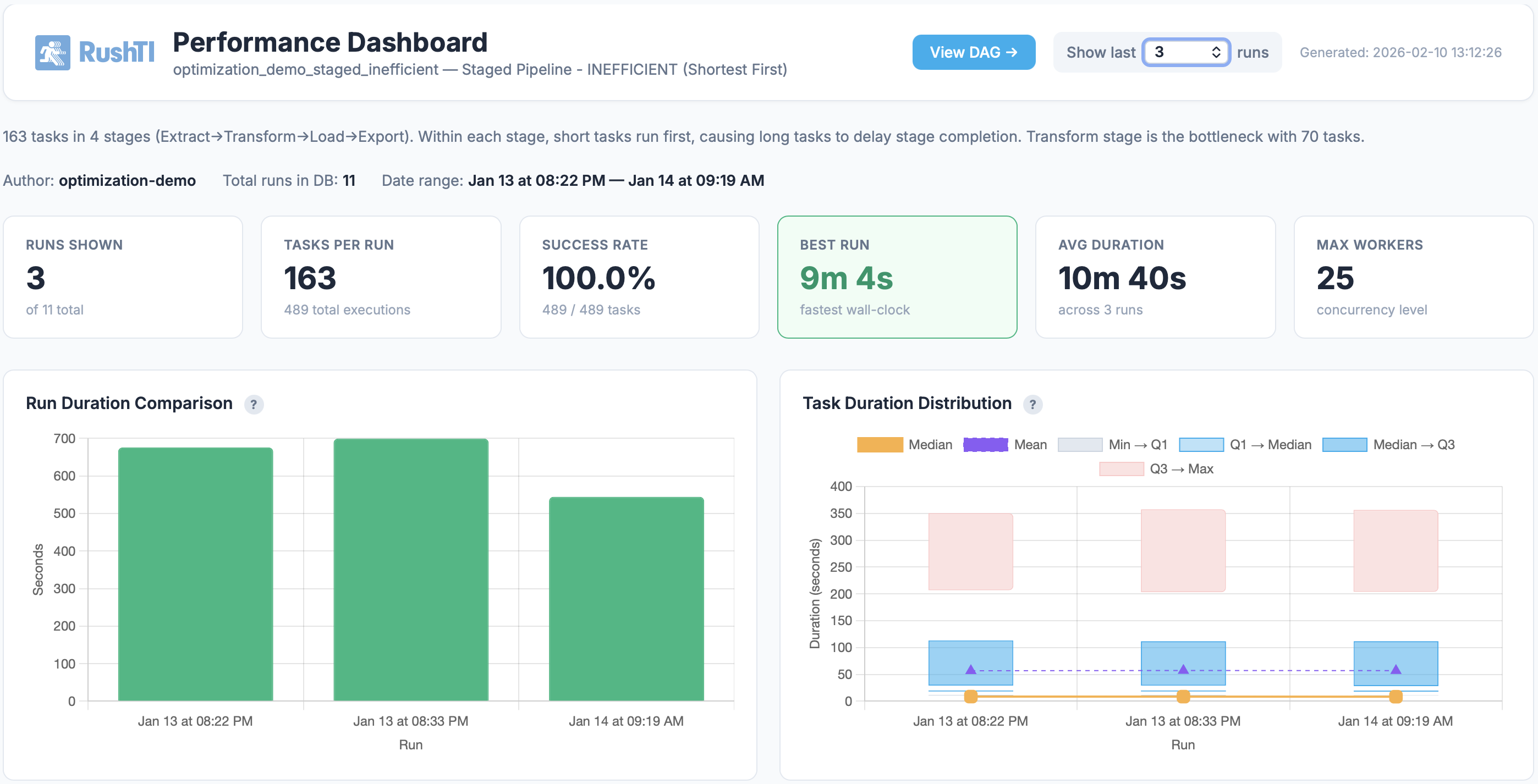

RushTI Dashboard
Interactive HTML dashboard generated with rushti stats visualize — run durations, task-level breakdowns, success rates, and concurrency timelines.

Working Example

Enable Stats

Add two lines to config/settings.ini:

[stats]
enabled = true
retention_days = 90

That's it. Every run is now tracked automatically.

Run a Workflow

rushti run --tasks daily-refresh.json --max-workers 4

After execution, check what was recorded:

rushti db list workflows
Workflows (2)
================================================================================
Workflow                                 Runs     Tasks    Last Run
--------------------------------------------------------------------------------
daily-refresh                            12       6        2026-02-09T10:15:00
finance-close                            3        13       2026-02-08T22:00:00

Generate a Dashboard

rushti stats visualize --workflow daily-refresh --output dashboard.html

Open dashboard.html in any browser to see an interactive dashboard with run durations over time, task-level breakdowns, success rates, and a concurrency timeline.

Share Dashboards With Your Team

The generated HTML file is fully self-contained — no web server needed. Email it to your team, save it to a shared drive, or open it directly from the file system in any browser.

Export to CSV

rushti stats export --workflow daily-refresh --output results.csv

Open the CSV in Excel or any reporting tool for further analysis.


CLI Commands Overview

Stats Commands

Command Description
rushti stats list runs --workflow ID List runs for a workflow
rushti stats list tasks --workflow ID List tasks for a workflow
rushti stats export --workflow ID Export run data to CSV
rushti stats visualize --workflow ID Generate interactive HTML dashboard
rushti stats analyze --workflow ID Analyze runs and suggest optimizations

Database Commands

Command Description
rushti db list workflows List all tracked workflows and run counts
rushti db show run --run-id ID Show details for a specific run
rushti db show task --signature SIG Show execution history for a task
rushti db vacuum Compact the database to reclaim disk space
rushti db clear Clear data (by workflow, run, date, or all)

What the Dashboard Shows

The HTML dashboard generated by rushti stats visualize includes several views:

Run Duration Over Time

A line chart showing total execution time for each run. Spot trends like gradually increasing runtimes (possibly due to growing data volumes) or sudden spikes (possibly a server issue).

Task-Level Breakdown

A stacked bar chart showing how long each task took within a run. Quickly identify which TI processes dominate your execution time.

Success Rates

A summary showing the percentage of tasks that succeeded, failed, or were skipped across all tracked runs. Use this to identify unreliable TI processes that need attention.

Concurrency Timeline

A chart showing actual concurrent tasks over time vs. the max_workers target (dashed line). Use this to verify that your DAG dependencies allow enough parallelization and that workers stay busy.

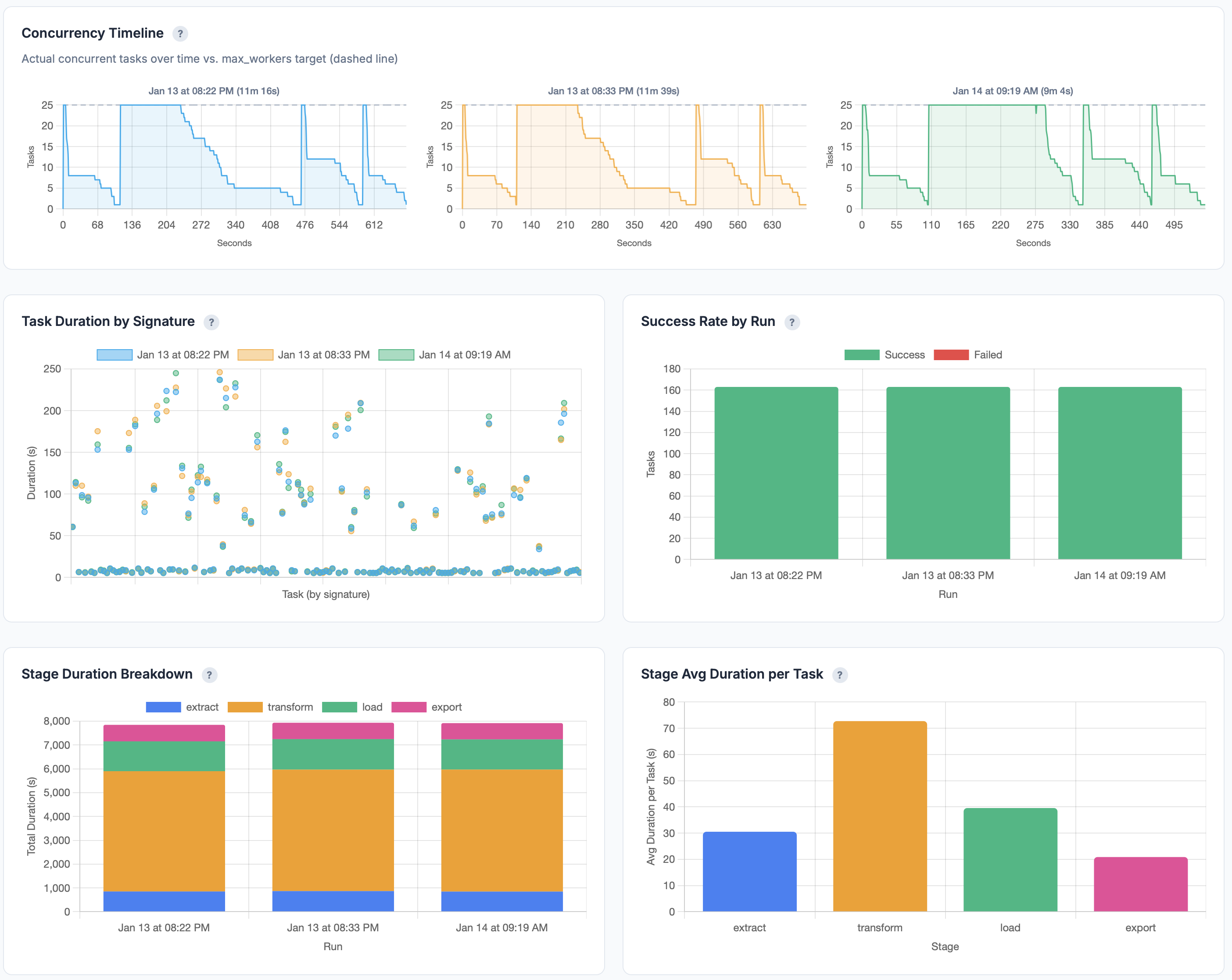

Concurrency Timeline
Concurrency timeline for each run — the blue/green line shows actual parallel tasks over time, the dashed line is the max_workers target. Gaps indicate idle workers; flat lines at the target indicate full utilization.

A Complete Workflow

Here is how stats, dashboards, and optimization work together in practice:

# 1. Enable stats in your settings
# (Already done in config/settings.ini)

# 2. Run your workflow (stats are captured automatically)
rushti run --tasks daily-refresh.json --max-workers 4

# 3. After a few runs, check what you have
rushti db list workflows

# 4. List recent runs for a specific workflow
rushti stats list runs --workflow daily-refresh

# 5. Generate a dashboard to review performance
rushti stats visualize --workflow daily-refresh --output dashboard.html

# 6. Export raw data for deeper analysis in Excel
rushti stats export --workflow daily-refresh --output results.csv

# 7. Analyze and generate an optimized task file
rushti stats analyze \
  --workflow daily-refresh \
  --tasks daily-refresh.json \
  --output daily-refresh-optimized.json

Configuration

Stats Settings

[stats]
enabled = true
retention_days = 90
Setting Default Description
enabled false Turn on statistics tracking
db_path data/rushti_stats.db Path to the SQLite database file
retention_days 90 Days to keep historical data. 0 = keep forever

Where Data Is Stored

The stats database is a single SQLite file, defaulting to:

data/rushti_stats.db

You can change the location via db_path in settings.ini:

[stats]
enabled = true
db_path = /var/data/rushti/stats.db

Relative paths are resolved from the application directory. No database server, no connection strings, no maintenance. The file is created automatically on the first run after enabling stats.

Taskfile Archive

Each run archives the taskfile as JSON under:

archive/{workflow}/{run_id}.json

This happens automatically regardless of the original source format (JSON, TXT, or TM1 cube). The archived taskfile allows historical DAG reconstruction for any past run — even if the original file has changed or been deleted. The taskfile_path column in the runs table points to the archived file.

Portable and Simple

You can copy rushti_stats.db to another machine, open it with any SQLite tool (like DB Browser for SQLite), and query your execution history directly with SQL.


What Gets Tracked

For every run, RushTI records:

Run-level data:

  • Workflow and path
  • Start time, end time, total duration
  • Task counts (total, succeeded, failed, skipped)
  • Settings used (workers, retries, exclusive mode)
  • Overall status (Success, Partial, Failed)

Task-level data:

  • TM1 instance and TI process name
  • Parameters passed to the process
  • Start time, end time, duration
  • Status (Success, Fail, Skipped)
  • Error message (if failed)
  • Retry count
  • Predecessors, stage, timeout settings

No Sensitive Data

The stats database stores execution metadata only. It does not store cube data, cell values, or TM1 credentials.


Database Management

List Tracked Workflows

rushti db list workflows
Workflows (4)
================================================================================
Workflow                                 Runs     Tasks    Last Run
--------------------------------------------------------------------------------
Sample_Stage_Mode                        2        5        2026-01-20T17:51:36
daily-refresh                            12       6        2026-02-09T10:15:00
finance-close                            3        13       2026-02-08T22:00:00
optimization_demo_staged_inefficient     11       163      2026-01-14T09:27:31

Compact the Database

After many runs, the database may have unused space from deleted records (retention cleanup). Compact it:

rushti db vacuum

Clear Data

Clear data by workflow, run, date, or everything:

# Delete all data for a specific workflow
rushti db clear --workflow old-workflow

# Delete a specific run
rushti db clear --run-id 20260115_103000

# Delete data older than a date
rushti db clear --before 2025-01-01

# Preview what would be deleted (without actually deleting)
rushti db clear --workflow old-workflow --dry-run

# Delete everything (requires confirmation)
rushti db clear --all

Irreversible

rushti db clear --all deletes all execution history. Use only when you need a completely fresh start.

Automatic Cleanup

When retention_days is set, RushTI automatically deletes records older than the retention period. Cleanup happens at startup and after each run.

[stats]
retention_days = 30     # Keep 1 month of history
retention_days = 90     # Keep 3 months (default)
retention_days = 365    # Keep 1 year
retention_days = 0      # Keep everything forever (monitor disk space)

Using Stats for Optimization

The statistics database directly powers RushTI's Self-Optimization feature. When optimization is activated (via --optimize <algorithm> on the CLI or optimization_algorithm in a JSON task file), RushTI uses historical data to reorder ready tasks during execution.

You can also manually generate an optimized task file:

rushti stats analyze \
  --workflow daily-refresh \
  --tasks daily-refresh.json \
  --output daily-refresh-optimized.json

See Self-Optimization for the full details.


Best Practices

1. Enable Stats From Day One

Even if you do not plan to optimize immediately, enable stats tracking from the start. It costs almost nothing in overhead and gives you historical data when you need it later.

2. Set Reasonable Retention

Balance storage space and analysis needs. For most teams, 90 days gives you enough history for optimization and trend analysis without letting the database grow too large.

3. Review Dashboards Monthly

Generate a dashboard once a month to catch performance trends early:

rushti stats visualize --workflow daily-refresh --output monthly-review.html

Look for:

  • Gradually increasing durations — Data volumes may be growing
  • Sporadic failures — Unreliable TI processes that need attention
  • Low worker utilization — Dependencies may be too conservative

4. Back Up the Database

The stats database is just a file. Include it in your regular backups:

cp data/rushti_stats.db data/rushti_stats_backup.db

Customize Further
